Skip to main content.
banner SLAC

1. FY06 PROGRESS FOR PEP-II
by John Seeman, Michael Sullivan, and Uli Wienands
Appendix B Self-Evaluation FY2006

Return to Table of Contents

General statements: PEP-II is a particle beam accelerator which collides 1722 bunches of electrons with 1722 bunches of positrons in two counter circulating storage rings to produce continuous luminosity to make B mesons in the BaBar physics detector. It is called a B-Factory. Each bunch contains about 100 billion particles. Each bunch collides on every turn of the accelerator or about 136,300 times per second.

Construction and installation of PEP-II was completed within budget in early July 1998. First collisions were observed in late July 1998 that was two months ahead of the final PEP-II DOE construction milestone. The BaBar detector was installed in May 1999. PEP-II has been delivering luminosity to BaBar nearly continuously over the past seven years. PEP-II exceeded its design luminosity (3 x 1033 cm-2s-1) in October 2000 by achieving 3.30 x 1033 cm-2s-1. Through steady progress, PEP-II has now exceeded, on August 16, 2006, over four times its design luminosity reaching 1.207 x 1034 cm-2s-1. The peak integrated luminosity in 24 hours has reached 911 pb-1 which is seven times the design of 130 pb-1 per day.

End of PEP-II Run 5a in early FY2006: The end of Beam Run 5a was from October 1 through 10 where PEP-II delivered luminosity to BaBar and did extra accelerator studies to increase the peak luminosity. This beam run in early FY2006 achieved several milestones for the PEP-II program. PEP-II exceeded 3.3 times its design luminosity on October 9, 2005, by achieving 1.003 x 1034 cm-2s-1. This luminosity level corresponds to giving BaBar over 1 million new particle physics events every day! This very high luminosity was reached using 1732 bunches with 2940 mA of positrons and 1740 mA of electrons, both record beam currents at the time. The vertical and horizontal beam sizes at the interaction region were about 4.0 by 125 microns, respectively. Furthermore, PEP-II delivered 728 pb-1 in one day to BaBar in early October 2004.

Installation period October 10 through November 15, 2005: There was an installation period for PEP-II where several new components were installed or upgraded and the overall accelerator safety systems were recertified. The original vacuum chambers in PEP-II (arcs and straights) were designed to handle twice the LER current and four times the HER current. However, to reach these higher currents the interaction region vacuum chambers need upgrading. Two of these chambers were exchanged. Several NEG pumps were removed from LER interaction region vacuum chambers which were being heated by beam Higher Order Modes (HOMs). All safety systems were checked.

PEP-II Operation: The operation of PEP-II collider (Run 5b) started in mid-November 2005, and ran until August 18, 2006. Over 100 fb-1 of data on and near the Upsilon 4S resonance were delivered to BaBar in FY2006.

The luminosity increases over the past year have come from several factors. Reducing βy*s from 11 to about 10 mm increased the luminosity by about 10%. The bunch spacing has been changed from the “By-2” (a bunch every second RF bucket) with mini-gaps to a full “By-2” without mini-gaps. This configuration has only one gap of about 15 missing bunches which is used as an abort gap. This “By-2” spacing has some (anticipated) parasitic crossing effects but the adverse affects were measured to be below a few percent in the luminosity, consistent with our beam-beam computer simulations. The new bunch spacing allowed more bunches to be collided which also allowed the beam currents to be increased with constant bunch current. The higher beam currents with the new RF stations are now about 2950 mA in the LER and 1900 mA in the HER. Both of these currents are world records for electron and positron storage rings. The betatron tunes were optimized near the half integer reducing the effects of the beam-beam interaction.

Much work has gone into improving the optical magnet lattice for both rings. This work has improved the machine performance by reducing the “beta” errors around the rings. The horizontal tunes have been moved closer to the half integer resonance allowing even higher beam-beam tune shifts. As a result, the specific luminosity (luminosity divided by the product of the beam currents) was at an all time high and was the cause of the most significant gain in the luminosity this past year. The optics-lattice group has done an excellent job.

Trickle injection was a great improvement for PEP-II in FY2004 and continued to improve in FY2005 and FY2006. An example of a good day with trickle injection is shown in the first figure below. Trickle injection for positrons uses about ten injection pulses per second from the linac, resulting in the positron current being stable to about 0.1%. The HER injection of electrons is about five Hz. The SLAC linac was designed to allow up to 40 injected positron pulses and also 40 electron pulses each second in any order, although fewer pulses are in fact actually needed. Thus, PEP-II has true trickle injection with very steady currents and steady luminosity. BaBar records better than 98% of the data in the trickle running mode. The PEP-II and BaBar groups are all very pleased with this improvement. All data taking is now with continuous injection.

There were five interrupting events in Run 5b: four of which needed vacuum intervention. 1) A gap ring for a vacuum flange in the Low Energy Ring (LER) in PEP-II Region 4 started to arc with the higher positron beam current. This gap ring was changed, fixing the problem. 2) The high power bellows near the Q2 magnet shared between the HER and LER ring in the interaction region developed an arc near the HOM absorbing tiles and the associated “Omega” RF seal. These two bellows were removed and a new Omega seal used to fix the problem was designed, built, and installed. 3) At high current two Beam Position Monitor (BPM) button heads in the LER physically dropped off near the interaction region. This problem has been seen before in FY2005 and has been carefully controlled since then. These button heads were successfully removed. For a global cure, all the LER BPMs in the interaction region and the dipole arcs will be replaced or removed during the Fall 2006 down, completely fixing this problem. 4) At high current an expansion bellows unit and three Omega seals in the High Energy Ring (HER) were damaged. These related problems are being addressed during the Fall 2006 down. 5) Finally, on August 18 during an accelerator machine studies period, a special bunch pattern (By-4) was used to study high bunch charge beam-beam effects and caused overheating in a cable near the transverse feedback kicker, subsequently causing a small cable fire. The fire was promptly and safety extinguished. The cause of the cable heating is now understood and will be fixed before the next run starts in January 2007.

The beam run in the FY2006 achieved new records in all performance milestones for the PEP-II program. PEP-II exceeded 4 times its design luminosity this year (August 16, 2005) by achieving 1.207 x 1034 cm-2s-1. This very high luminosity was reached using 1722 bunches with 2900 mA of positrons and 1875 mA of electrons, both record beam currents. The vertical and horizontal beam sizes at the interaction region were about 3.8 by 130 microns, respectively. Furthermore, PEP-II delivered 911 pb-1 in one day to BaBar in July 2006. This rate is 7 times the design delivered luminosity per day of 130 pb-1/day. Thus, the luminosity delivery efficiency is excellent. The total integrated luminosity delivered to BaBar in FY2006 was 100.3 fb-1, bringing a total so far of 410 fb-1 for the life of PEP-II.

The achievements of FY2006 for PEP-II can be seen in the nine figures below. The first figure shows a good day with trickle injection, stable beam currents and steady luminosity. The next figure shows the peak luminosity in each month since PEP-II started up with BaBar in May of 1999. Note that the PEP-II luminosity passed 1.2 x 1034/cm2/s on August 16, 2006. The next figure shows the daily integrated luminosity indicating PEP-II can deliver solidly over 800 pb-1 per day. The next figure shows the daily average luminosity each month with August 2006 being by far the best month. The next figure shows the monthly integrated luminosity for PEP-II since the collider started operation FY1999. Over 19.3 fb-1 has been delivered to BaBar in a 30 day period in July 2006. The next plot shows the total integrated luminosity with time over Run 5a and Run 5b indicating a total of 153.8 fb-1 over that time. The following plot shows the total integrated luminosity since May 1999 indicating that PEP-II has delivered to BaBar over 410 fb-1. The next table shows the operational records of PEP-II, highlighting our peak luminosity of over 1.2 x 1034/cm2/s. The final chart shows our integrated luminosity and run time statistics for the four fiscal quarters of FY2006.

PEP-II installation in August and September 2006: PEP-II entered a shut-down-maintenance period August 21, 2006, to do safety related activities in the tunnels and to install new hardware for increasing the luminosity. There are about a dozen projects associated with increased luminosity. New HER Q4L, Q4R, and Q5R vacuum chambers in the interaction region will be installed to improve the HER vacuum pressure with beam current and BaBar backgrounds. New LER vacuum chamber Q4R&L and Q5R&L will be installed to allow high beam currents. A beam spoiler will be reworked upstream of the LER abort dump to protect the vacuum window from cracking from high peak currents. A tenth HER RF station is being installed to increase the ring’s current capability to over 2 A. New beam position monitor (BPM) units will be installed in the LER dipole arcs to improve their high current capabilities. A HER vacuum transition chamber will be changed with a higher power unit. A higher power expansion bellows will be installed near a collimator in LER in PEP-II Region 10 which is in a higher HOM power region. New power supplies are being added to the HER ring to allow the betatron tunes to be increased to shorten the bunch length, which allows a smaller vertical beta in the interaction region increasing the luminosity. All of these tasks are planned to be completed in the August through December 2006 shut-down. The restart of PEP-II is anticipated for early January 2007.

PEP-II DOE Performance Measure: The DOE HEP integrated luminosity measure for FY2006 for PEP-II was 100 fb-1. The actual integrated luminosity delivered by PEP-II in FY 2006 was 100.3 fb-1 which meets the goal.

Figures for PEP-II performance in FY2006:

PEP-II beam currents and luminosity for 24 hours in July 2006 showing the stability of continuous (trickle) injection and very high average luminosity approaching 1.1 x 1034.

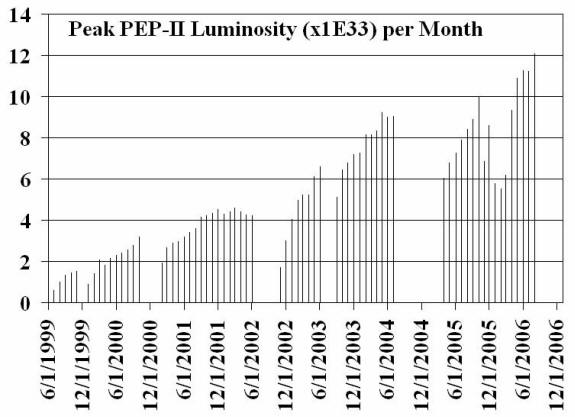

PEP-II peak luminosity in each month since May 1999.

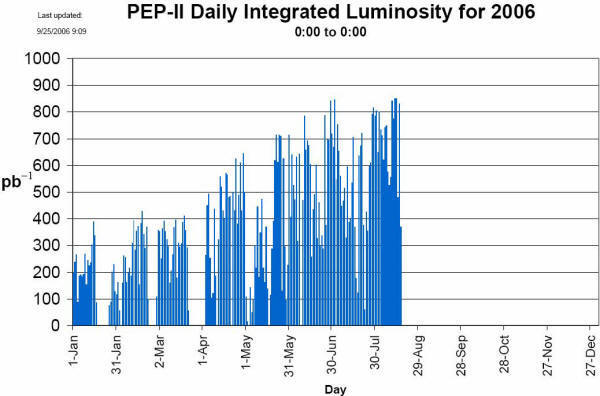

PEP-II Daily Integrated Luminosity for CY2006 showing very strong progress.

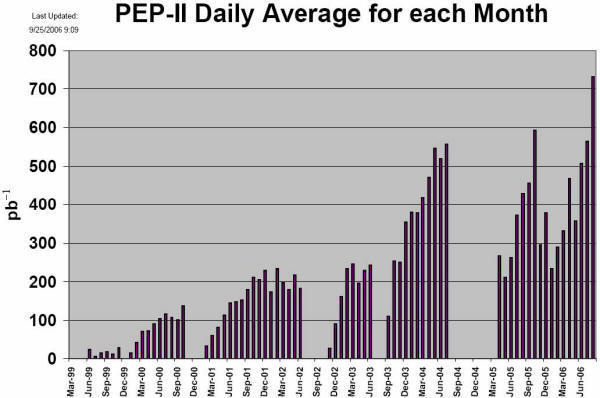

PEP-II Daily average integrated luminosity for each month showing strong improvement at the end of the Run 5b.

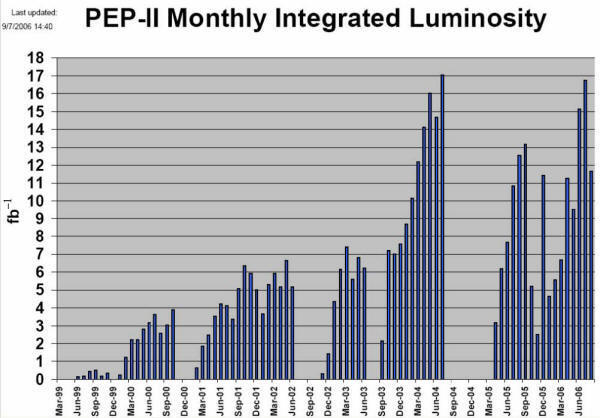

PEP-II integrated luminosity per month showing steady improvement.

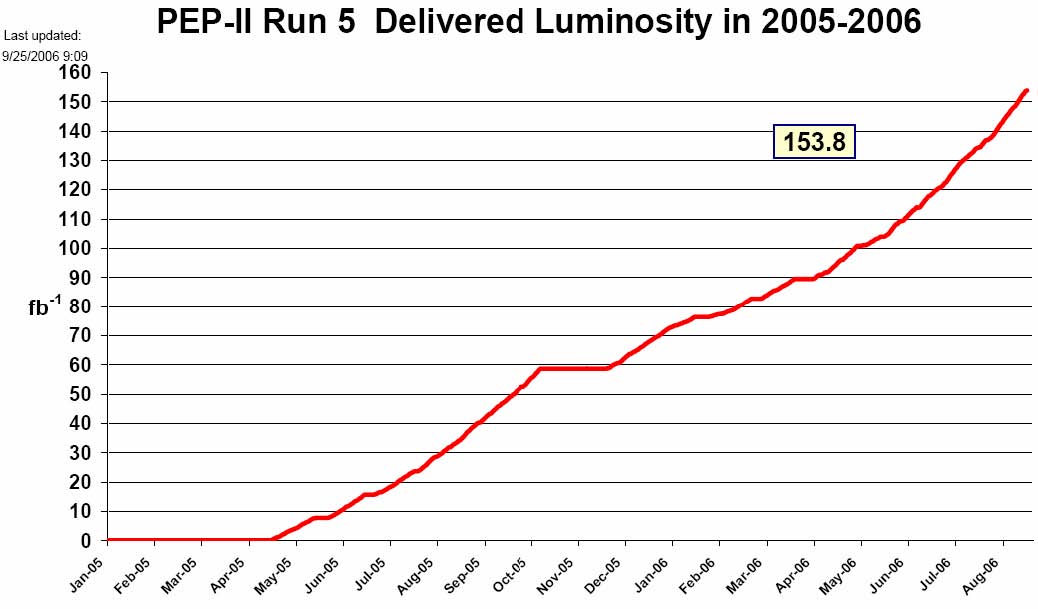

PEP-II accumulated integrated luminosity during FY2006.

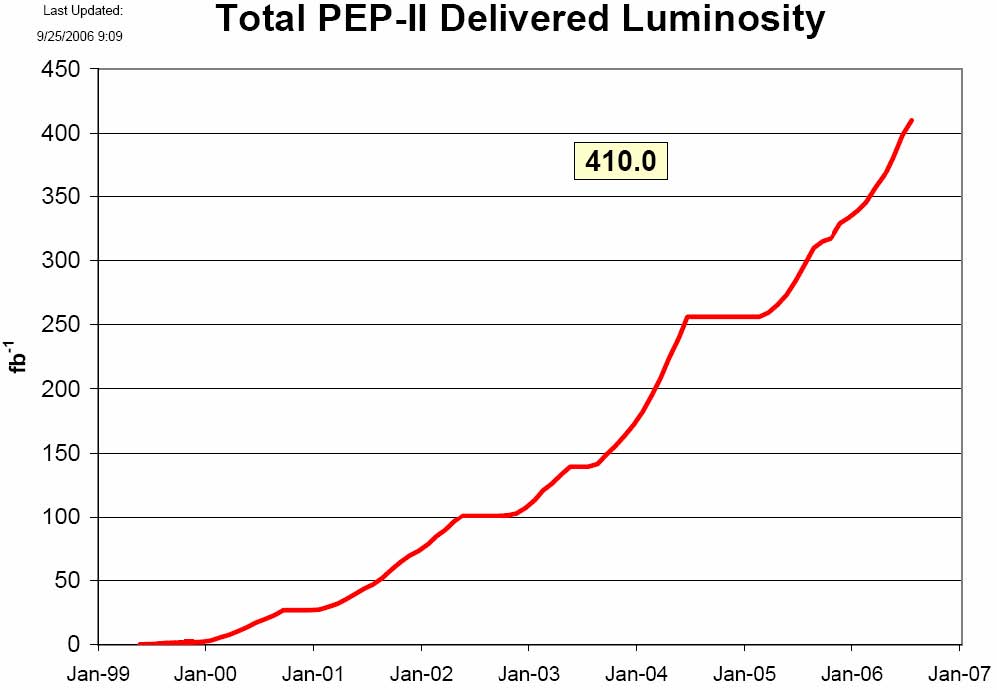

PEP-II accumulated integrated luminosity since May 1999.

PEP-II overall performance records
